Seismic Approach to Quality Management of HMA MnDOT Contract No. 1034287 Federal Project Number: TPF-5 (341) Execution: January, 2020 - December, 2021
|
PROJECT PROGRESS (January, 2020)
|

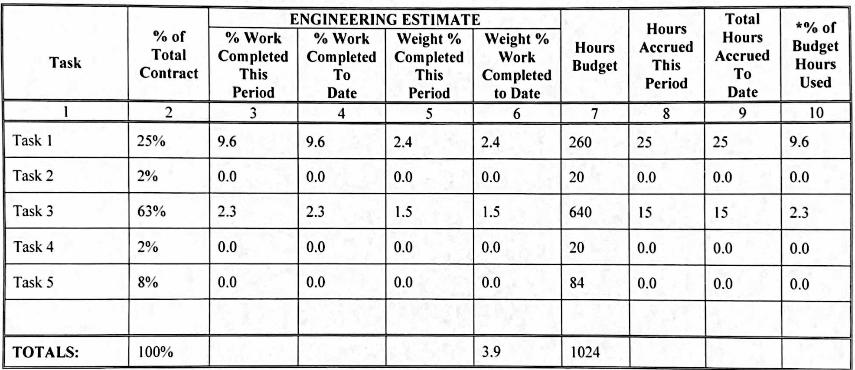

Progress Table (Prime Contractor - Park Seismic LLC) - January, 2020
|

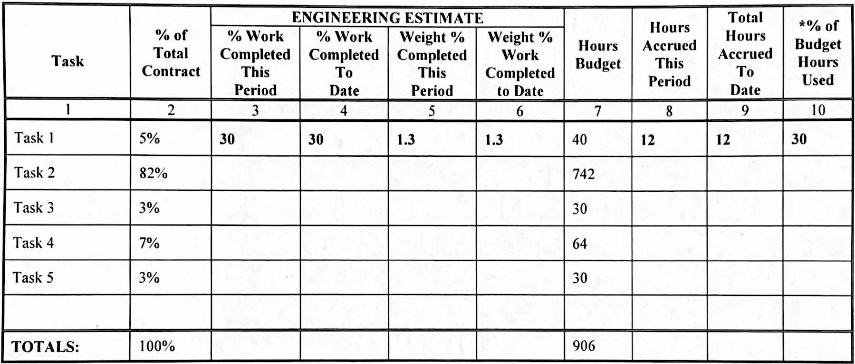

Progress Table (Sub Contractor - Norrfee Tech) - January, 2020
|
Summary
The project officially started as of January 6, 2020. As each participant was revisiting the original project proposal, scope of work,
description of tasks, and the project schedule, technical contents and the overall work flowchart were discussed for clarification of
assigned tasks and interaction with other participants' tasks. General frameworks of the hardware and software were drafted.
Blueprints for hardware system building and software package development were prepared. Early clarification of potential issues in the
hardware, software, administrative, and budgetary aspects has been attempted. Communication methods among all participants were
discussed. A dedicated web site (this HMA site) was planned to open soon for public access. A blog was also to be prepared soon as a
means to post each participant's outcomes for mutual communication and calibration purposes. This blog will be open only among the
project participants.
Technical and administrative contents of the project were prepared to present during the Kickoff and the 1st TAP (Technical Advisory
Panel) meeting scheduled on January 23, 2020. Temperature calibration, which may be necessary during the dispersion analysis of
Lamb waves, was briefly discussed as the topic was raised during the TAP meeting as a potential issue.
Project Tasks | Summary (see details)
Task 1: Project Management and Administration
Task 2: Hardware Development (Seismic Data Acquisition System) & Testing
Task 3: Software Development & Testing
Task 4: Delivery and Demonstration of Seismic Data Acquisition System and Software
Task 5: Final Report
Year 1 (2020):
Year 2 (2021):
